Project Overview
Ann Arbor has been awarded a 2022 Safe Streets for All (SS4A) United States Department of Transportation Supplemental Action Planning Grant.
Due to the nature of the Grant funding, demonstration activities will be carried out through feasibility studies, limited to the use of quick-build strategies, to inform future permanent projects.

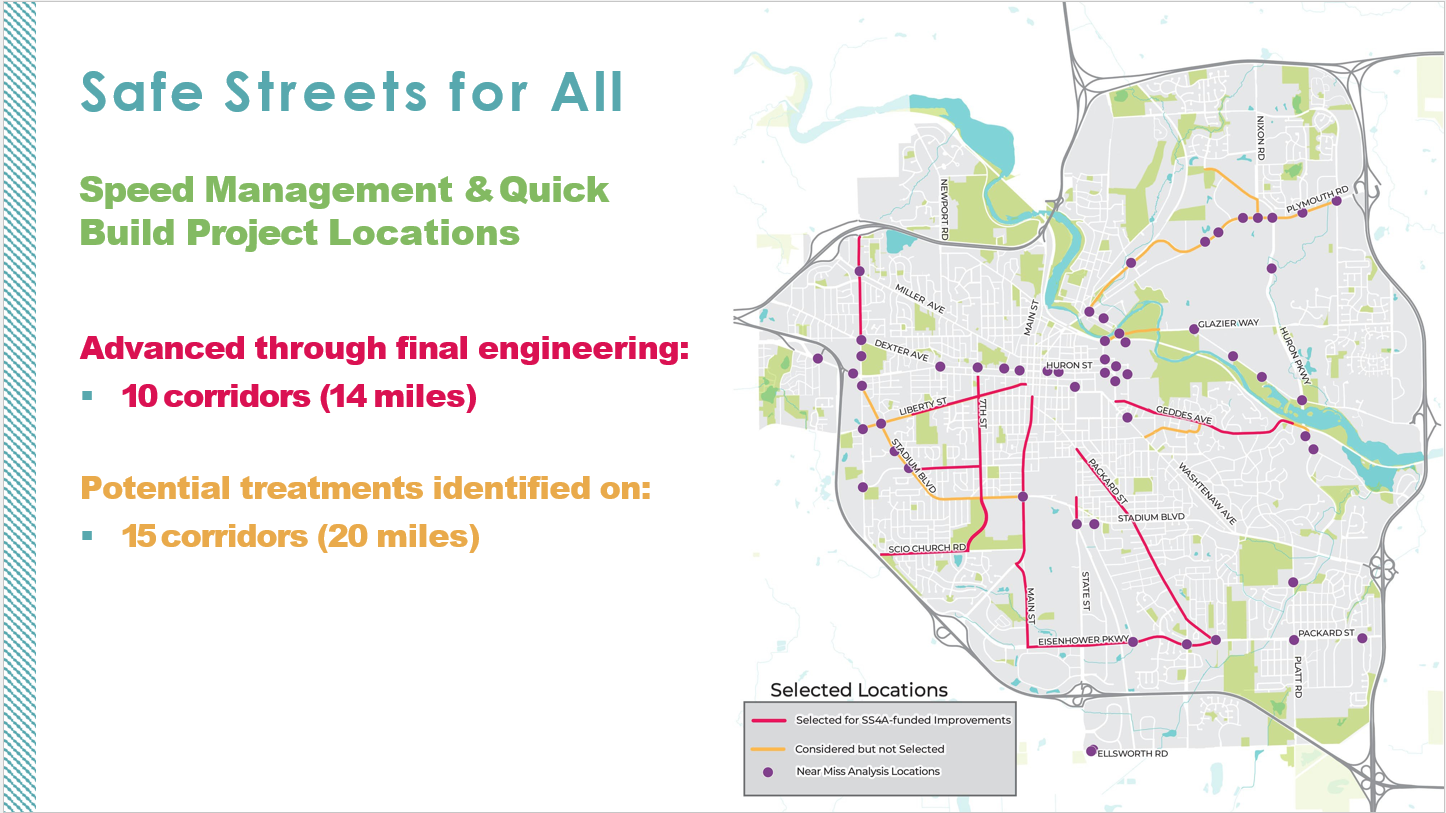

Acting on the mobility strategies identified in the Transportation Plan, the Project will deploy a suite of traffic safety improvements using quick build treatments on up to 15 speed management corridors and up to 20 intersections prioritizing previously identified high crash “focus” locations. The Project builds on the City’s quick-build improvement program, which has enabled the City of Ann Arbor to create safer streets for all users with the urgency needed to achieve its Vision Zero goal by 2025.
Proposed Project Corridors:

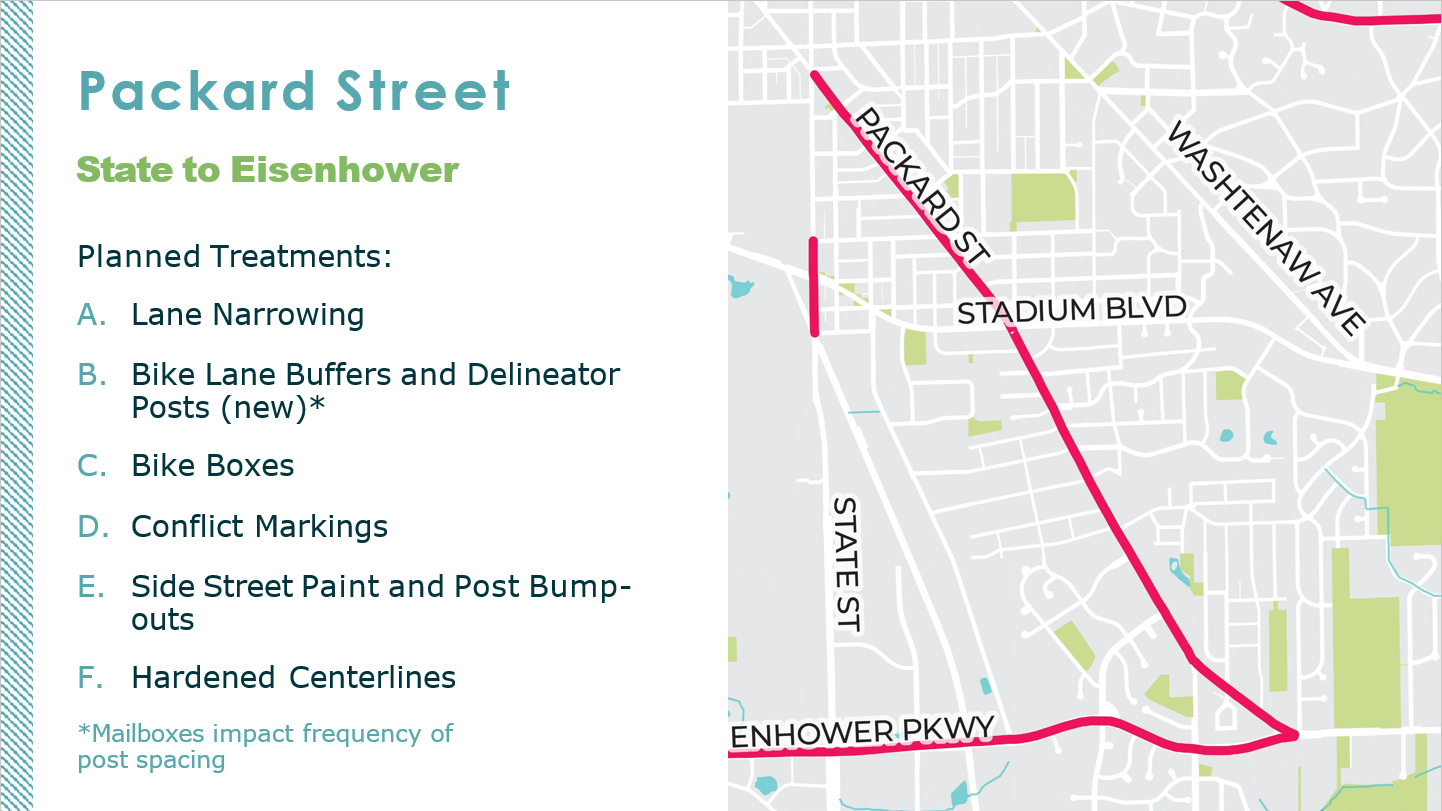

- Packard Street (State to Eisenhower)

- Liberty Street (Maple to Main)

- State Street (Granger to Simson)

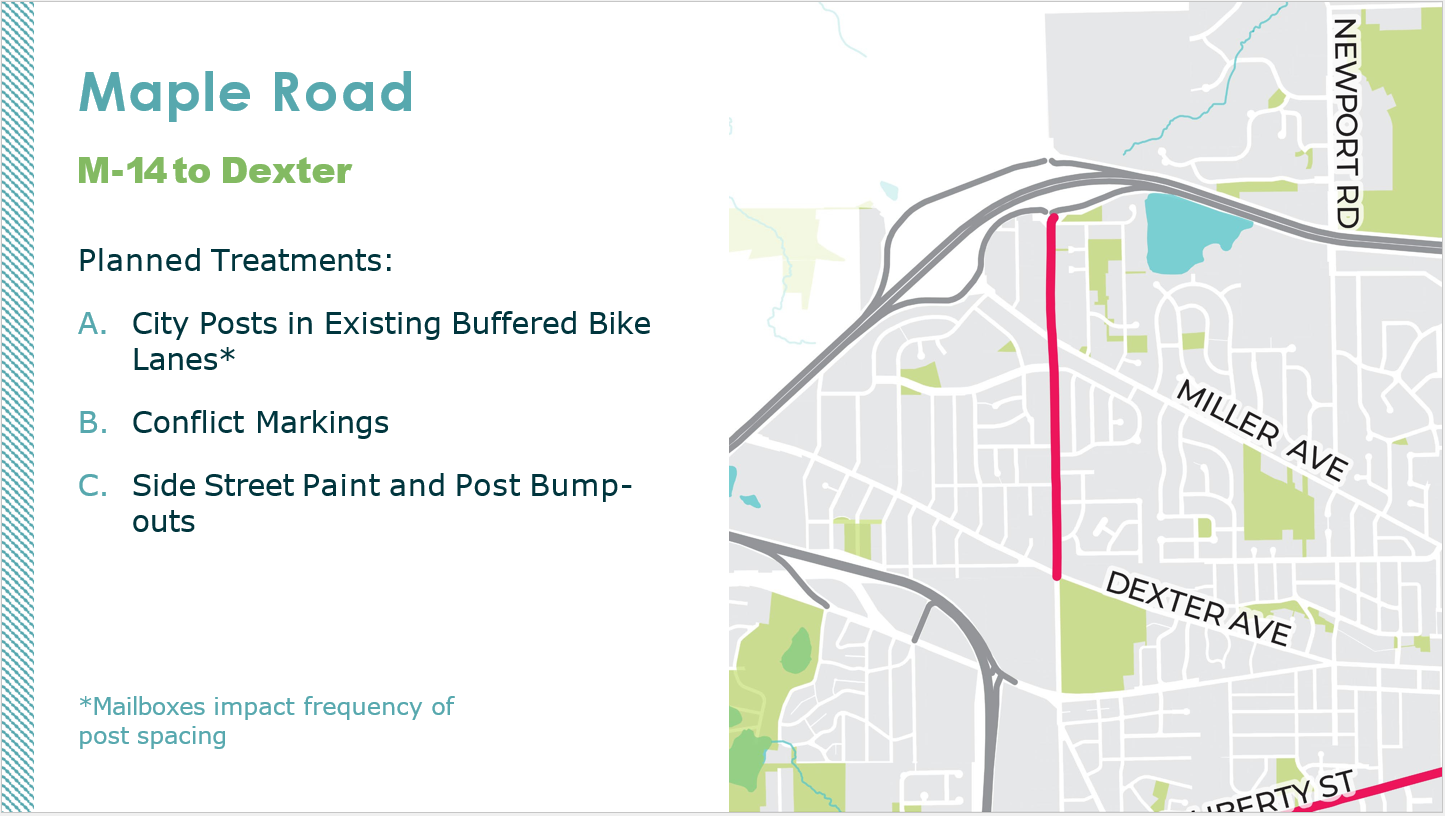

- Maple Road (Dexter to M-14)

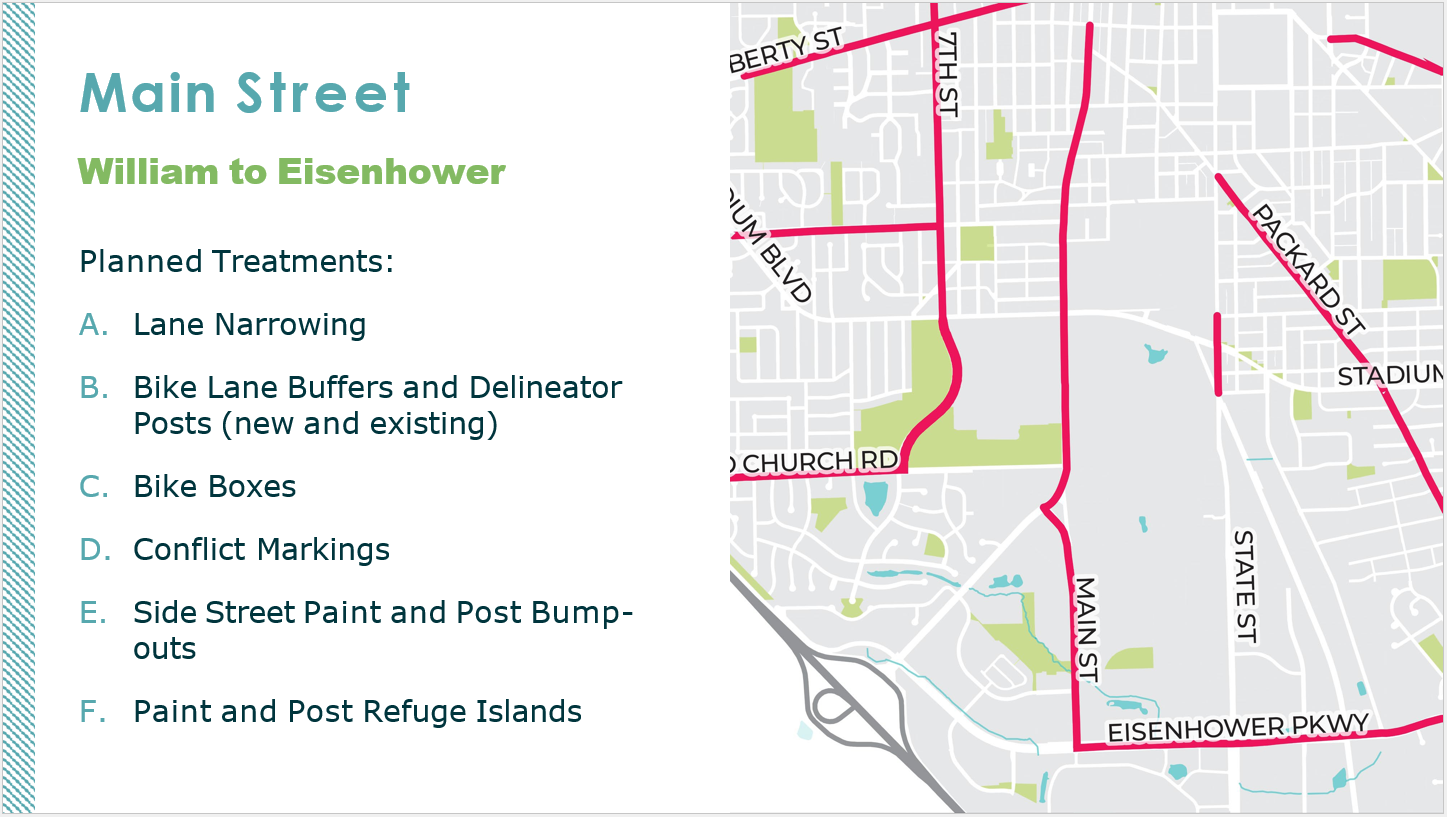

- Main Street (William to Eisenhower)
- Eisenhower Parkway (Main to Packard
- 7th Street (Scio Church to Washington)

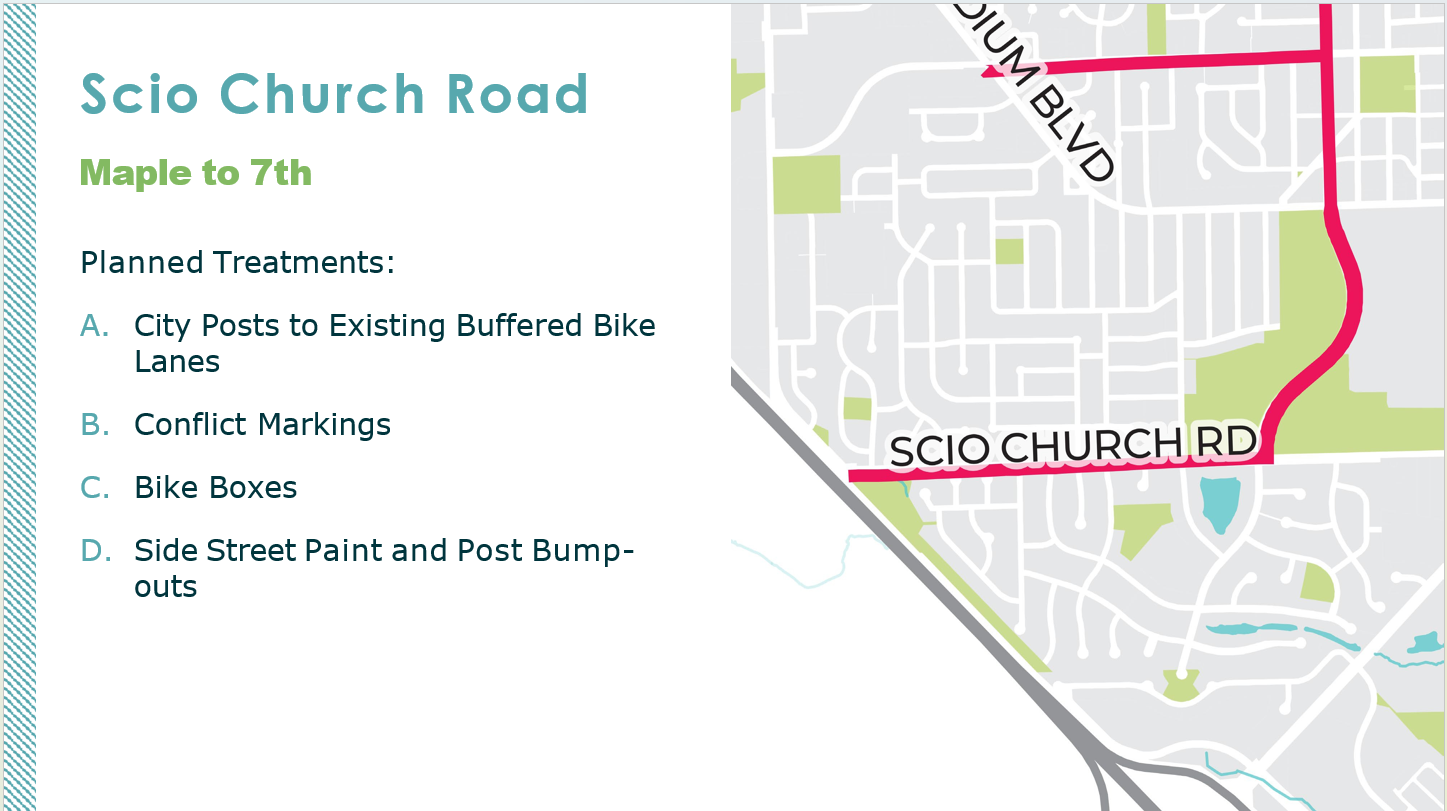

- Scio Church Road (Maple to 7th)

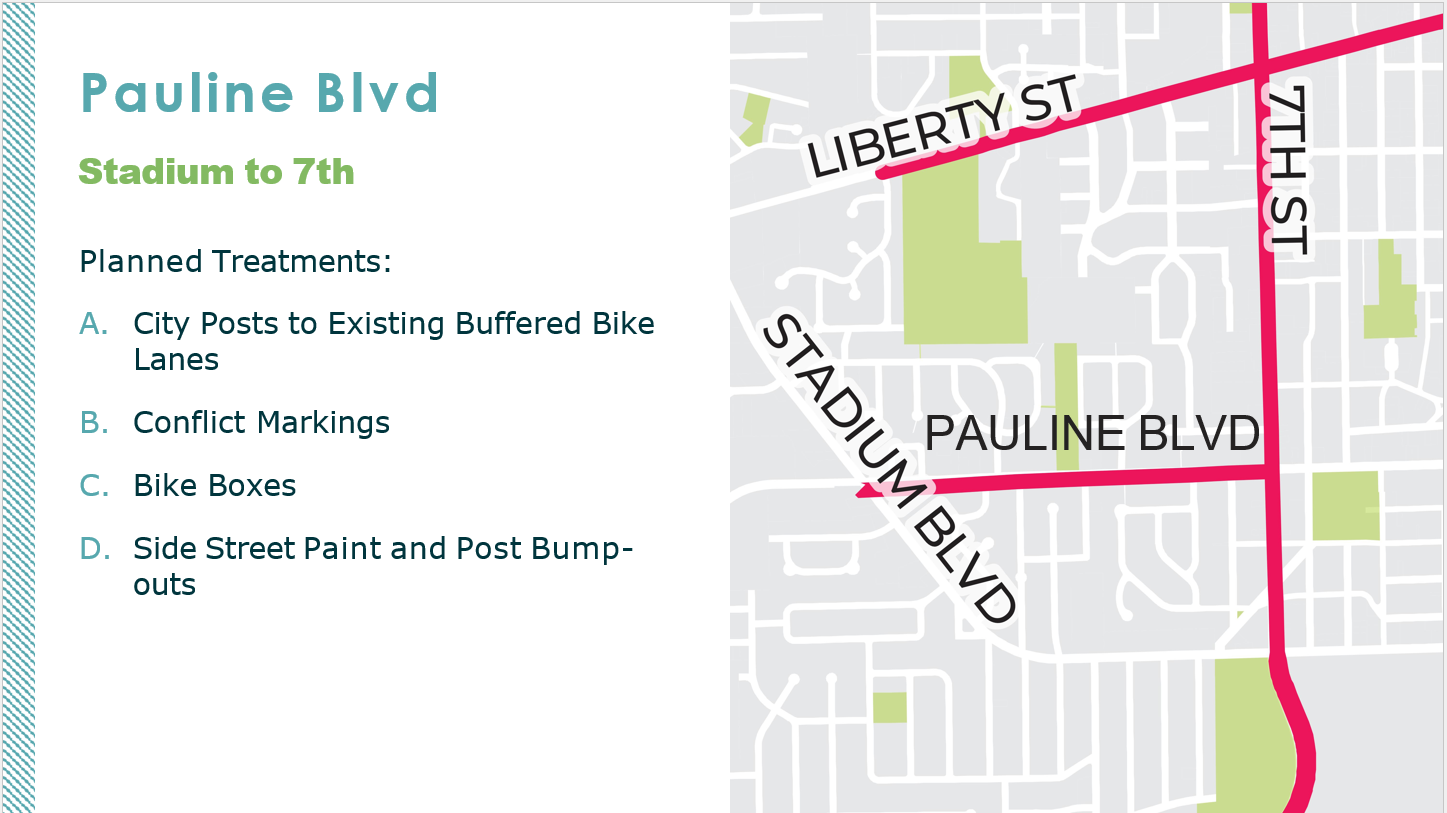

- Pauline Boulevard (W Stadium to 7th)

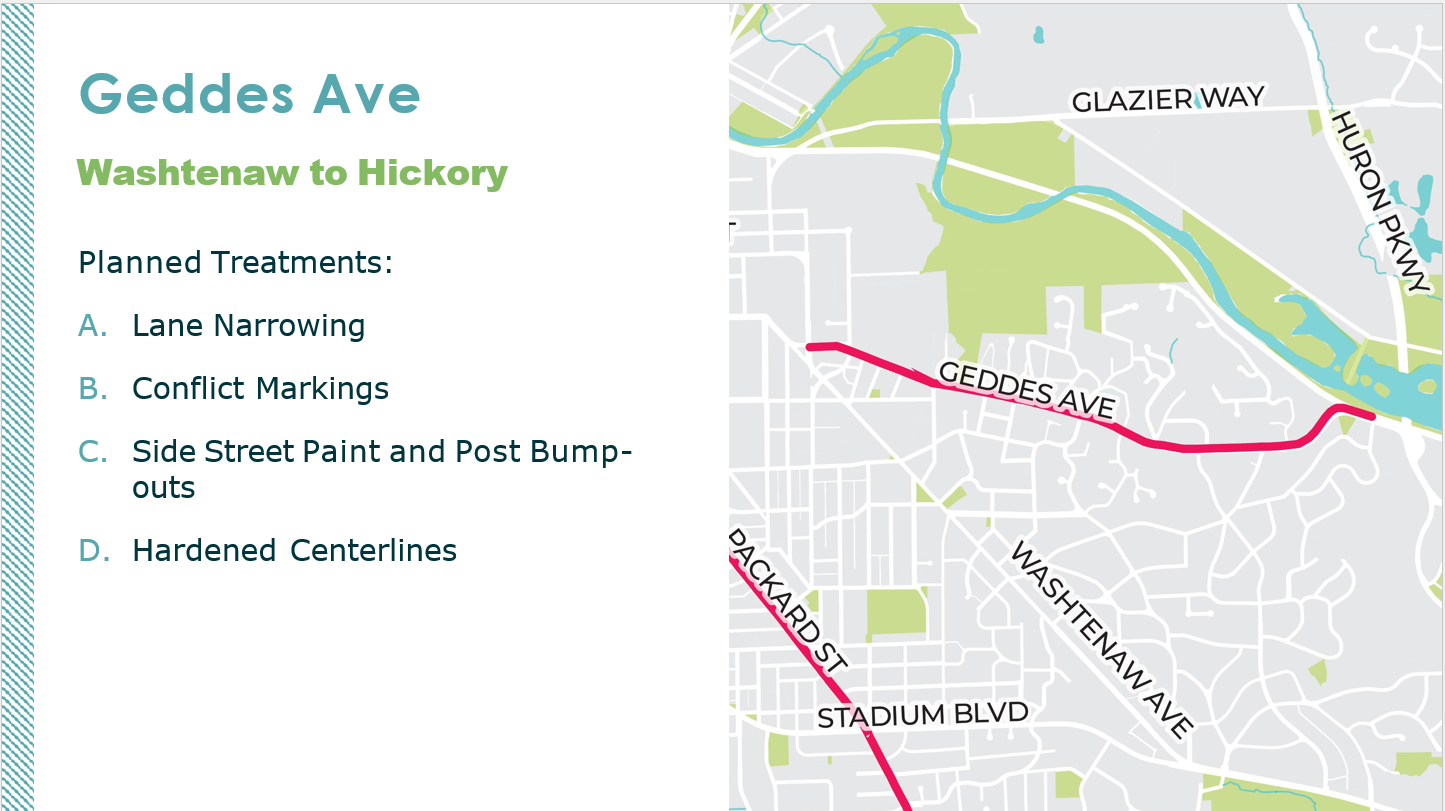

- Geddes Street (Washtenaw to Huron Parkway)
Why is this project being done?
Ann Arbor was awarded a federal Safe Streets and Roads for All (SS4A) supplemental action planning grant for project elements: Speed Management, Quick Build and Near Miss Video Analytics system.
Work to be done
The City of Ann Arbor’s FY 2022 demonstration grant will apply treatments through the lense of the Safe System approach adopted by USDOT through the National Roadway Safety Strategy.
The demonstration project will advance the City and USDOT’s shared goals to reduce and eventually eliminate deaths and serious injuries from roadway crashes.
Through this grant, the City of Ann Arbor will design and deploy systemic safety countermeasures to inform the City’s safety action plan across 17 miles of roadways, including 13 miles of the City’s high injury network.
The grant cost-effectively delivers on three strategies included in Ann Arbor’s Transportation Master Plan: High Crash Locations, Addressing Dangerous Behaviors, and Quick Build Treatments.
The scope of improvements includes FHWA Proven Safety Countermeasures and systemic treatments consistent with national best practices and those recently deployed and tested by the City. These include:
- Pavement markings, signage, and temporary delineators that encourage compliance with existing posted speed limits, including predictable, consistent lane widths appropriate to Ann Arbor’s urban context.
- Pavement markings that make all users more visible and aware of one another, particularly in high-conflict areas like major intersections, including conflict markings, guide markings, and high visibility crosswalks.

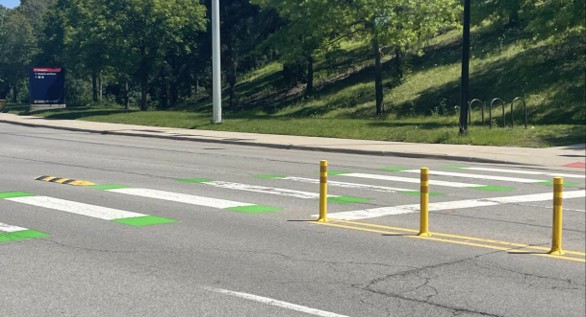

- Use of pavement markings and temporary delineators to indicate where users should travel including hardened centerlines to prevent unsafe turns that may impact people crossing and waiting vehicles

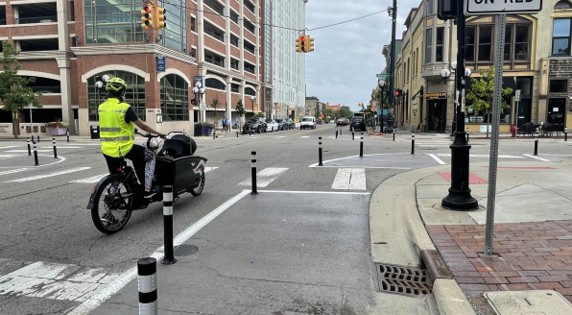

- Tightening curb radii to slow turns and reduce crossing distances for pedestrians through paint-and-post bump outs.
- The scope of improvements does not include any road diets or changes to capacity at intersections.
Near Miss Video Analytics System – utilizing existing Gridsmart cameras at 61 city intersections to understand factors that lead to crashes and “near miss” events. The City will be partnering with University of Michigan Transportation Research Institute to complete this work.
Funding Sources
$3.8 million federal funds
$950,000 local climate millage funds
Project Selection
A project selection memo is available to outline how the preliminary list of corridors and intersections were selected for the Quick Build and Speed Management grant elements.
- Construction is slated for Spring/Summer/Fall 2027
- There may be impacts during installation of the Speed Management and Quick Build projects across the city.
September/October 2025
January 30, 2025 Survey
The Safe Streets for All program survey closed on January 30, 2025.
- Survey Summary (PDF)
- Survey Results (PDF)
January 7, 2025 Virtual Q&A Session
- Meeting video (YouTube)
- Question and answer summary (PDF)
September 2026
- Presentation (PDF)
Completed Work
- Near Miss Burn In Period (Jan-Feb 2026)
- Public Engagement, SS4A Program Survey (Jan. 2025)
- Concept Development (Jan-Feb. 2025)
- NEPA Permitting (Jan. 2025)
- Public Engagement, Part 2 (Sept/Oct 2025)
- Public Engagement Phase 2
- Mayor's Green Fair (Sept. 19. 2025)
- Bikeapalooza (Sept. 20, 2025)
- Virtual Office Hours (Sept. 30, 2025)
- Ann Arbor Farmer's Market (Oct. 1, 2025)
- Mallet's Creek Library (Oct. 7, 2025)
- Presentation at Transportation Commission (Oct. 15, 2025)
Learn More

Project Corridors and Planned Treatments
Quick Build Tools
Archived Resources

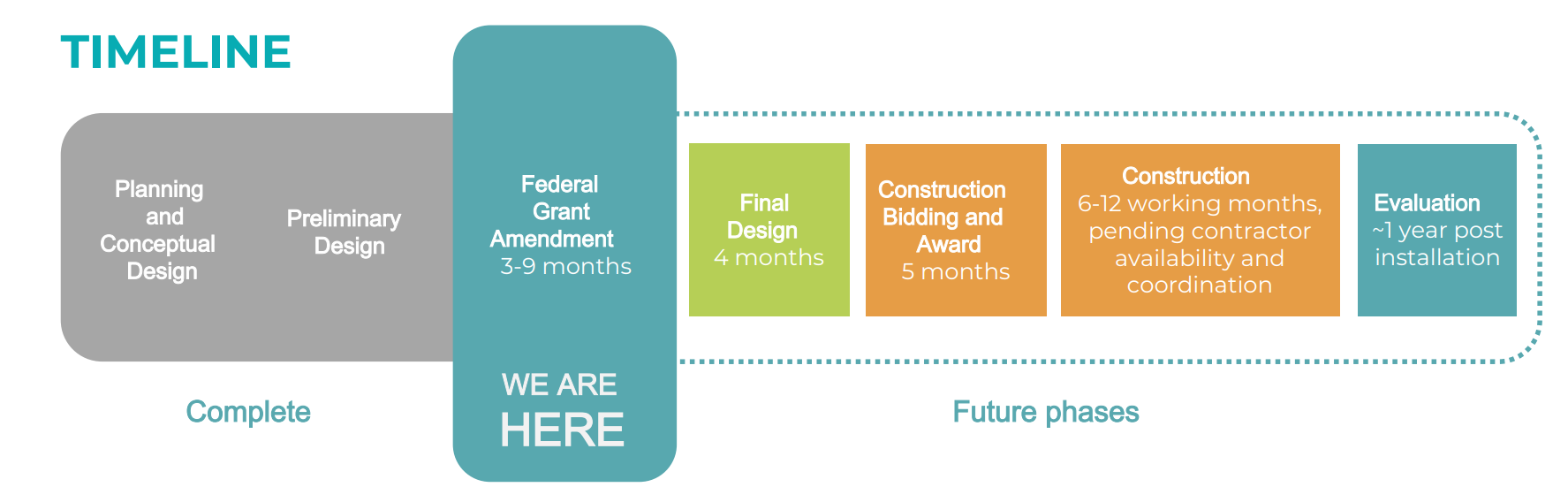

Detailed Project Timeline

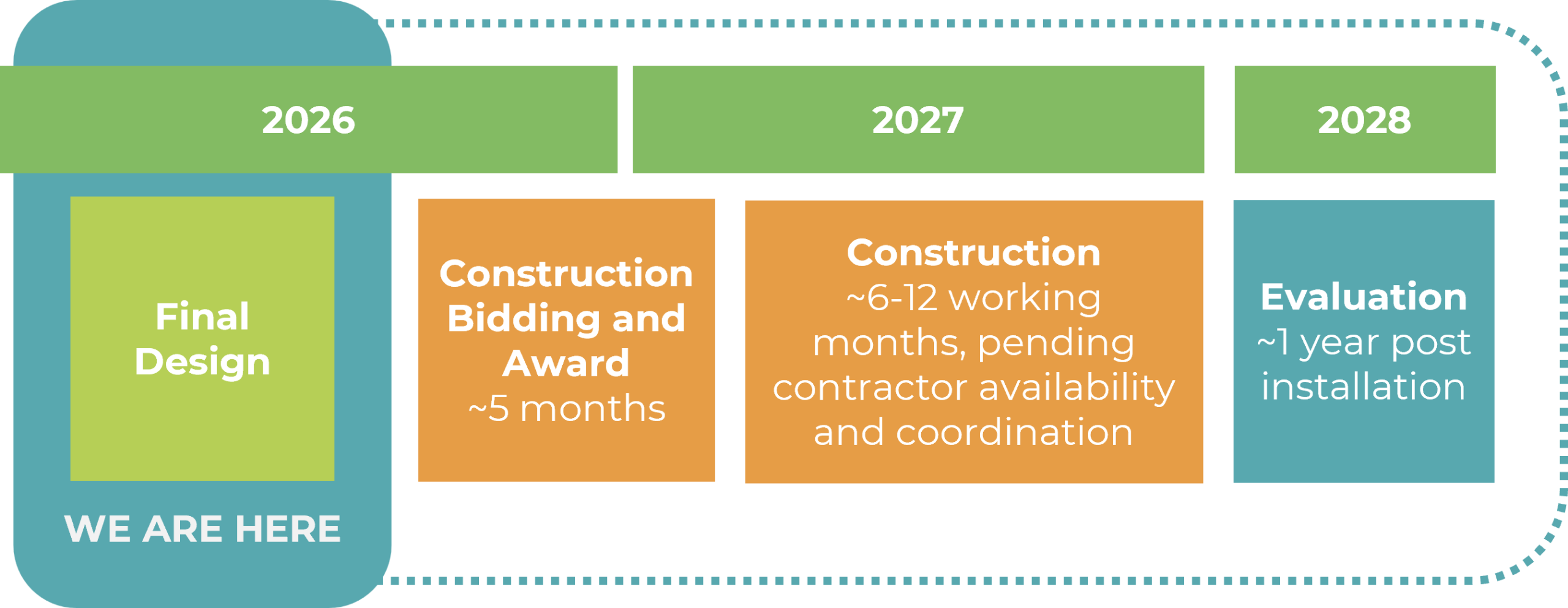

The Safe Streets for All project has a preliminary schedule identifying the following activities over the duration of the project:
Calendar Year 2026
- Final Grant Agreement Amendment - The city has received the final grant agreement amendment in February. The project can now move forward to final design and construction phases.
- Final Design - Creation of engineering plans for the design treatments that people will see along the study corridors and intersections across the city.
- Bidding-Developed engineering plans will be put out for competitive bids.
Near Miss Locations
Data on near miss events in various intersections across the city of Ann Arbor.

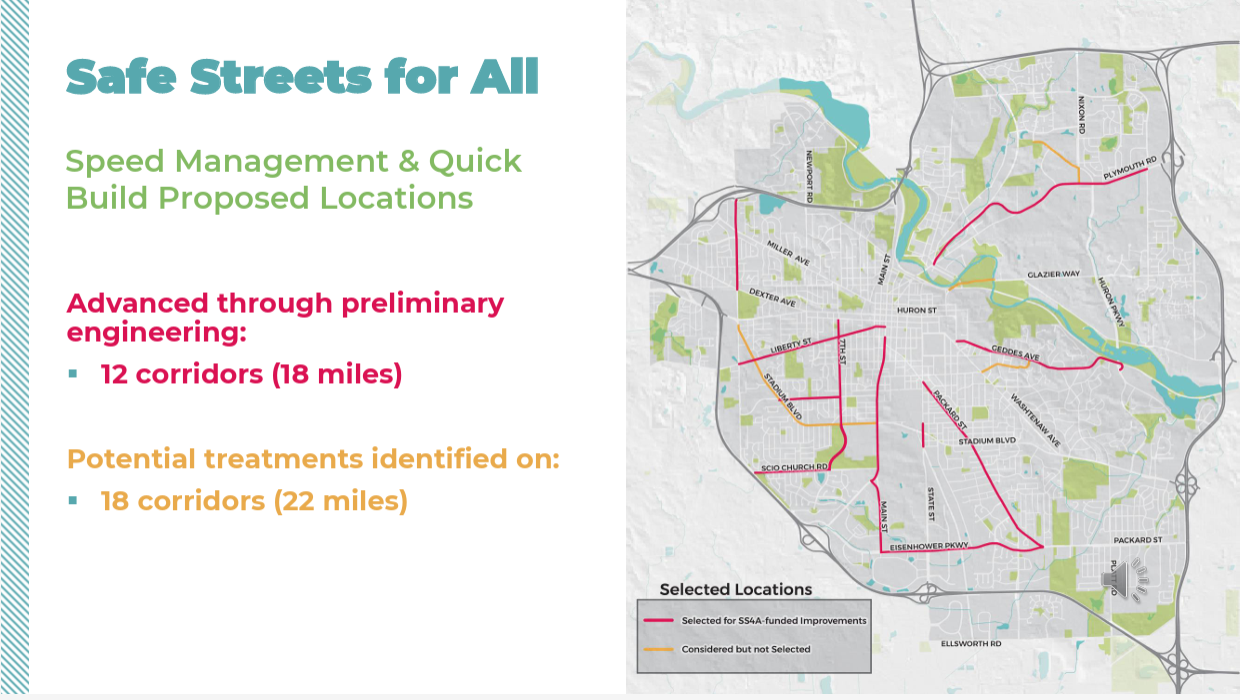

Project Locations: Quick Build & Speed Management
Potential locations for quick build and speed management projects around the city of Ann Arbor.
